NetSingularity
NetSingularity
Complete lifecycle coverage · Stage 01

Network rollout tracked in one workspace. Not scattered across email and spreadsheets.

From the first site candidate to the final acceptance test, your rollout teams, vendors and contractors work from a single source of truth. Delays surface early, nothing falls through, and the as-built record you finish with is one your operations team can actually trust.

NetSingularity plan to build network rollout lifecycle with GIS planning, survey, design, procurement, commissioning and HOTO
The rollout reality

The schedule is not the problem.
The handoffs are.

Every rollout stage produces data the next stage needs, and in most programmes that data travels by attachment. A design lands in a contractor's inbox. A field team captures as-built on paper. Someone re-keys it into a spreadsheet three weeks later. By the time the site is live, nobody can say with confidence what is actually in the ground.

Cost

Delays found late

A permit that stalled in week two surfaces in the week-nine status call, when the recovery options have already expired.

Cost

Re-mobilisation

Defects caught by the carrier after handover mean sending crews back, and holding invoices for weeks while it is resolved.

Cost

Inventory born wrong

If as-built never reconciles with design, every downstream system inherits the error, and assurance spends years working around it.

The rollout chain

One record per site, updated in place.
And the loop that keeps design honest.

Each stage reads and writes the same site record rather than passing a copy along. The stage that matters most is the last one: as-built capture reconciled against the original design, so what goes into inventory is what is actually in the ground.

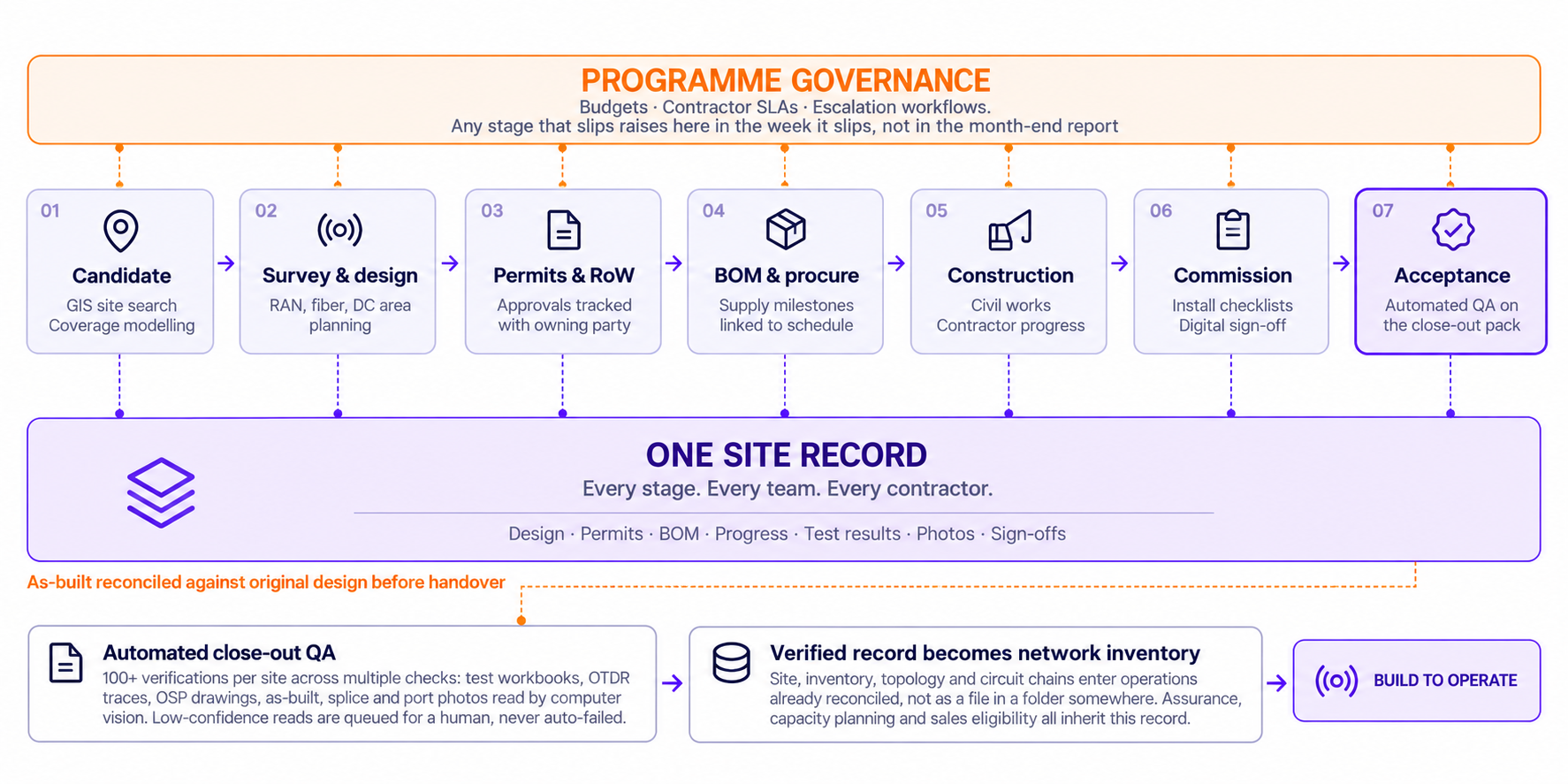

PROGRAMME GOVERNANCEBudgets · contractor SLAs · escalation workflows. Any stage that slips raises here in the week it slips, not in the month-end report01CandidateGIS site search,coverage modelling02Survey & designRAN, fiber, DCarea planning03Permits & RoWApprovals trackedwith owning party04BOM & procureSupply milestoneslinked to schedule05ConstructionCivil works,contractor progress06CommissionInstall checklists,digital sign-off07AcceptanceAutomated QA onthe close-out packslippage escalates the moment it is detectedONE SITE RECORD. Read and written in place by every stage, every team, every contractorDesign · permits · BOM · progress · test results · photos · sign-offs. No attachments, no re-keying, no second copy to reconcileas-built reconciled against the original design. Every discrepancy raised before handoverAutomated close-out QA300+ verifications per site across 12 checks: test workbooks, OTDR traces,OSP drawings, splice and port photos read by computer visionLow-confidence reads are queued for a human, never auto-failedDefects caught here cost nothing. Defects caught by the carrier cost a re-mobilisation.Verified record becomes network inventoryPassive plant, active inventory, topology and circuit chains enter Build toOperate already reconciled, not as a PDF in a folder somewhereAssurance, capacity planning and sales eligibility all inherit this recordInventory quality is decided here, at stages 01 to 07. Not fixed later.STAGE 02 · BUILD TO OPERATE
The seven stages are ordinary. What changes the outcome is the band beneath them: every stage reads and writes one shared site record, so there is never a second copy to reconcile. The orange return path is the part most rollouts skip. As-built measured against the design that was approved, with discrepancies raised while crews are still mobilised rather than after the carrier rejects the package.
Plan to build

What the stage actually delivers.

GIS-based site planning

RAN · fiber · data centre

Candidate search, coverage modelling and route planning on real geography, with demographic and competitive context layered in, so the business case and the engineering case are argued from the same map.

End-to-end fiber lifecycle

Area planning to as-built

Area planning, right-of-way approvals, construction progress and as-built capture in one chain, with each permit tracked against the party who owns it rather than the person who last chased it.

Installation, commissioning and acceptance

Digital sign-off

Checklists executed in the field on a device, with evidence attached at the point of work and sign-off recorded against a named person. The close-out package assembles itself as the work happens.

BOM, procurement and supply chain

Linked to the schedule

Material requirements derived from the design, purchase orders tracked to delivery, and supply milestones bound to project dates, so a late shipment moves the plan instead of surprising it.

Programme governance

Budgets · contractor SLAs · escalation

Budget consumption, contractor performance against SLA, and escalation workflows that fire on the condition rather than on the status meeting. Vendor accountability stops being an argument about whose spreadsheet is right.

Measured on live rollouts

What operators got.

< 2 hrsO-RAN site turn-up, down from a full day. Tier-1 Canadian operator, thousands of nodes.
ZeroManual data entry, via automated planning sync and QR / serial / MAC capture in the field.
300+Automated verifications per site across 12 QA checks on fiber close-out packages.
Days → < 1 hrClose-out QA cycle time, including human review of flagged exceptions.

One splice, caught in time

On a 30-unit MDU, a fiber measured 0.695 dB loss against a 0.333 dB threshold. Flagged pre-submission, avoiding a carrier rejection and the re-mobilisation behind it.

~$850 to $1,500 saved per site

Full-coverage QA labour versus manual sampling, at a loaded rate of $75 to $100 per hour. Plus $800 to $1,500 per avoided rejection cycle.

1 to 3 weeks of cash pulled forward

Invoices that would have been held through a reject-and-fix cycle clear on first submission instead.

Results measured on one operator's programme are not a forecast for yours. Every engagement starts by baselining your own rejection rate and QA effort, so the comparison is honest on both sides.

Inherited a mess?

Acquisition-era data is the normal starting point.

Most operators do not start from a clean sheet. They start from a decade of mergers, with passive plant in one GIS platform, active inventory in another system, faults in a ticketing tool and the rest in spreadsheets carried over from each acquired business. That is a solvable problem, and it is solved before autonomy is worth discussing.

Correlate, then decide

Silos are loaded and cross-referenced into one model first, so you can see what is missing before committing to a migration.

A digital twin, not a report

Layered aerial and underground views, end-to-end circuit visibility, building-to-port drill-down. Built on your live data, not a sample.

Assets you forgot you owned

One proof of concept surfaced free and stranded fiber available for resale, unutilised card and port capacity, and circuit anomalies indicating real gaps.

Spanning every stage

Where this hands off.

Resource Management and the NOC run across all four stages. That is why the as-built record produced here is the same record assurance queries tomorrow.

Worth a conversation?

Send us one close-out package.

Pick a site you have already handed over, ideally one that got rejected. We will run it through automated QA and show you what would have been caught before submission, and what would have been queued for a human instead. No integration required to find out.

Worth a conversation
with your team?

Tell us where you're losing the most ground. We'll show you exactly where Netsingularity fits. And where it doesn't. A structured technical walkthrough on your use case, your data patterns.

Share the use case, team context, and email. We'll follow up with a focused walkthrough for your network lifecycle priorities.
